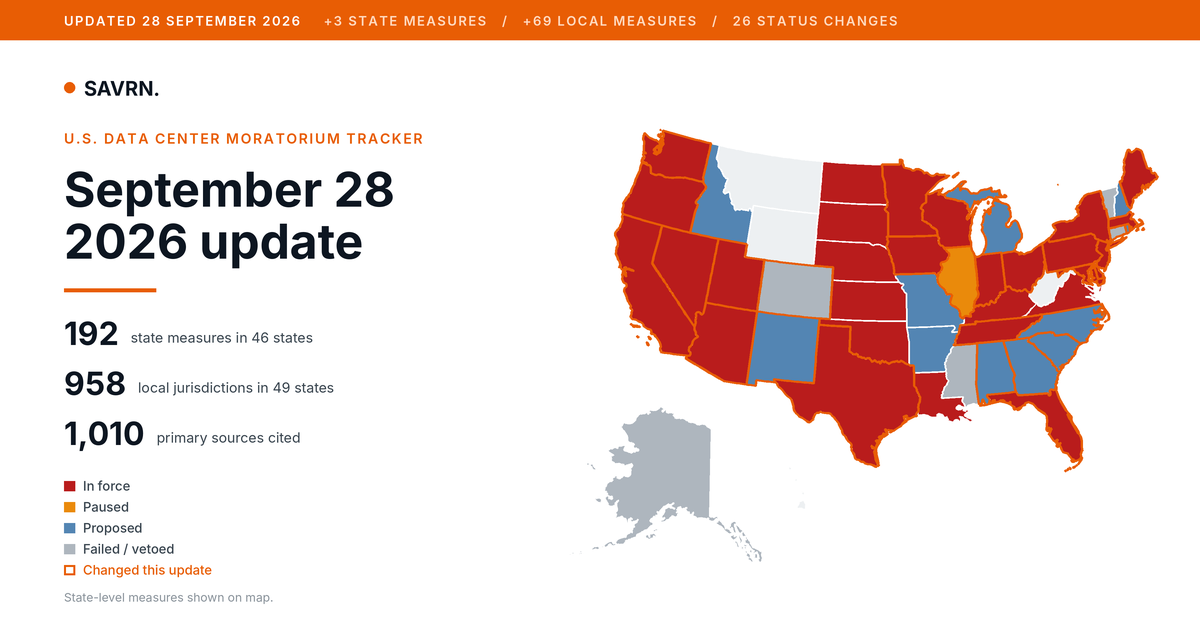

Data Center Moratorium Tracker Update: September 28, 2026
192 state-level measures across 46 states and 958 local jurisdictions, each linked to its primary source.
The U.S. Data Center Moratorium Tracker was refreshed on September 28, 2026. This is the record of what changed since the previous refresh on September 23, 2026. Every entry below links to the primary source behind it.
Where the count stands
| Measure | Previous | Current | Change |
|---|---|---|---|
| State-level measures | 189 | 192 | +3 |
| States with state-level action | 45 | 46 | +1 |
| Local jurisdictions | 889 | 958 | +69 |
| States with local action | 49 | 49 | 0 |
| Primary sources cited | 942 | 1,010 | +68 |
Of the 46 states with a state-level measure on the tracker, 29 have a restriction in force, 1 are under an active administrative pause, 11 have a measure pending, and 5 saw their most advanced measure fail or be vetoed.
New state measures this period
- Maryland, Executive Order 01.01.2026.16: Responsible Data Center Development framework and review task force. Gov. Wes Moore signed an executive order on Sept. 23, 2026, effective immediately, creating a Maryland Data Center Task Force that reviews every data center of 25 MW or more that seeks any state action, rates each as Aligned, Conditionally Aligned or Not Aligned with a five-part framework, and publishes a monthly public dashboard. It does not pause construction; state permits, approvals and incentives are to be informed by each project’s alignment with the framework. Source
- Nevada, Executive Order 2026-005: Nevada Standard for Responsible Data Center Development. Gov. Joe Lombardo signed Executive Order 2026-005 on Sept. 18, 2026, adding conditions to the state’s data center tax abatement program. Applicants must pay the Local School Support Tax in full, cover project-related costs so they are not passed to ratepayers, meet local water standards and execute a binding Community Support Commitment before applications go to the GOED Board. It is not a moratorium. Source
Newly verified state measures from earlier periods
These actions were taken before this reporting period and were added once a primary source was confirmed. They are research gains, not new activity.
- Delaware, HB 310: Large energy-use facilities barred from job-creation tax credits. Gov. Matt Meyer signed HB 310 on Aug. 26, 2026, as part of a four-bill energy consumer protection package. It prohibits large energy-use facilities such as data centers from receiving the state’s job-creation tax credits. Source
Status changes, state measures
- California, AB 1577: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 434, Statutes of 2026). Creates data center reporting obligations to the California Energy Commission, including energy use and local land use disclosures. Source
- California, AB 2383: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 435, Statutes of 2026). The Fair Share in Energy Act adds Public Utilities Code provisions on electricity service to data centers. Source
- California, AB 2469: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 436, Statutes of 2026). Requires data center water use disclosures. Source
- California, SB 1168: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 440, Statutes of 2026). Establishes data center electricity rate structure provisions in the Public Utilities Code. Source
- California, SB 886: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 438, Statutes of 2026). The California Technology Innovation and Ratepayer Protection Act directs the CPUC to adopt data center tariffs that assign transmission upgrade costs to data centers. Source
- California, SB 887: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 439, Statutes of 2026). Amends CEQA provisions covering environmental leadership development projects, data centers and geothermal power plant projects. Source
- California, AB 2619: Proposed to In force. Signed by Gov. Newsom on Sept. 21, 2026 (Chapter 437, Statutes of 2026). Requires data centers to report annual water use. Source
- Delaware, HB 233 (Substitute 1): Proposed to In force. House Substitute 1 for HB 233 was signed by Gov. Matt Meyer on Aug. 26, 2026 (Chapter 85:440). It requires a separate utility rate class for large energy-use facilities of 20 MW or more, such as data centers, so infrastructure and capacity costs are not shifted to other customers. Source
- Delaware, HB 445: Proposed to In force. Signed by Gov. Matt Meyer on Aug. 26, 2026. Requires large energy-use facilities such as data centers to produce or secure 100 percent of their required power (bring your own generation). Source
- California, AB 222: Proposed to Failed / vetoed. AB 222, which would have required data center energy use reporting, was held under submission in committee on Aug. 29, 2025 and saw no further action before the 2025-26 session ended on Aug. 31, 2026. Source
New local measures this period
- Northport, AL: Data center moratorium not pursued. At a September 21, 2026 work session, Northport city leaders declined to pursue a data center moratorium and instead directed staff to recommend zoning provisions for where a data center could be located. No formal moratorium vote was reported. Source
- Arcata (Humboldt County), CA: 45-day urgency moratorium on data centers. Arcata City Council unanimously adopted an urgency data center moratorium that halts permit processing for 45 days, with a likely extension of up to 10 months and 15 days. The vote was the evening of Sept. 16, 2026. Source
- Los Angeles County, CA: Interim prohibition on large-scale data centers in unincorporated areas. The Los Angeles County Department of Regional Planning issued a memo on September 18, 2026 immediately prohibiting large-scale AI data centers in unincorporated areas while zoning amendments are codified. The action follows an April motion approved unanimously by the Board of Supervisors. Source
- Riverbank (Stanislaus County), CA: 45-day urgency moratorium on data centers. Riverbank City Council unanimously approved a 45-day moratorium on data centers on Sept. 9, 2026, effective immediately through Oct. 13, with the option to extend. The source reports a unanimous vote but not an explicit 5-0 tally. Source
- Riverside, CA: Proposed 90-day data center moratorium. The Riverside City Council Land Use Committee voted unanimously on September 14, 2026 to recommend that the full council adopt a 90-day urgency moratorium on new data center proposals while staff defines data centers and drafts permanent rules. No full council vote date was reported. Source
- Loveland, CO: 12-month suspension of large data center applications. Loveland City Council voted 7-2 in mid-September 2026 to suspend processing of land use applications for data centers requiring 10 megawatts or more. The suspension lasts 12 months or until the council adopts new data center regulations, whichever comes first. Source
- Moffat County, CO: Proposed six- or 12-month data center moratorium. Moffat County commissioners on September 8, 2026 unanimously postponed a decision on a proposed six- or 12-month moratorium on data center applications in unincorporated areas, planning further public meetings before revisiting it on October 13. Source
- Americus, GA: 30-day data center moratorium. The Americus City Council voted 5-1 to enact a 30-day moratorium on data centers to allow time to draft an ordinance amendment regulating them; the city attorney noted the council can extend it if needed. Source
- City of Galesburg, IL: 180-day data center moratorium. Galesburg City Council voted 7-0 to adopt a 180-day moratorium on accepting, processing or approving data center permits, through April 3, 2027, after a 6-1 vote to move it to final reading. Source
- Owen County, IN: One-year data center moratorium. Owen County commissioners unanimously approved a one-year moratorium on new data center development and rezoning for data center use while the plan commission drafts permanent regulations. Source
- Zionsville (Boone County), IN: One-year moratorium on data centers, solar, wind and battery storage. Zionsville Town Council approved a one-year moratorium on data centers, solar farms, wind farms and battery energy storage systems, directing the plan commission to review land use rules. Source
- Hancock County, IA: Proposed data center moratorium (tabled). The Hancock County Board of Supervisors tabled a proposed data center moratorium, with only one supervisor supporting it; the board said it would focus on a comprehensive ordinance instead. Source
- Dover-Foxcroft, ME: Proposed six-month ban on large-scale data centers. The Select Board was considering a six-month ban on large-scale data center development in September 2026, with passage expected by the end of the month. Source
- Old Town (Penobscot County), ME: Proposed six-month data center moratorium. Old Town City Council voted unanimously Sept. 8, 2026 to advance a proposed 180-day moratorium on data centers in industrial zones, retroactive to that meeting, with a special council meeting set for Sept. 21 and two more meetings required before final approval. No confirmation of any Sept. 21 or 22 action was found. Source
- Peru, ME: Proposed 180-day data center moratorium (November ballot). The Selectboard approved placing a 180-day moratorium on data center construction before voters in November 2026. Source
- Ayer (Middlesex County), MA: Proposed temporary moratorium on data center applications. Ayer’s town planner presented a proposed data center moratorium zoning bylaw to the Select Board on Sept. 15, 2026 for the Fall Special Town Meeting on Oct. 26, 2026. The claimed Sept. 22 date was not found in official records. Source
- Boston, MA: Proposed citywide zoning ban on data centers. City Councilor Miniard Culpepper proposed a zoning code amendment in September 2026 that would define data centers and prohibit new facilities citywide, with exceptions for institutional and business server rooms. The change requires Boston Zoning Commission approval. Source
- Spencer, MA: Proposed data center moratorium. The Select Board voted unanimously in September 2026 to ask the Planning Board to pursue a 12-month data center moratorium and zoning rules, with the aim of bringing it to the fall Town Meeting. Source
- Brighton Township (Livingston County), MI: Six-month moratorium on data center applications. The Brighton Township board adopted a six-month moratorium on new data center applications to review its zoning ordinance, which does not address data centers. No application was pending. Source
- Dearborn, MI: Dearborn City Council gives first reading to six-month data center construction halt ordinance. Dearborn City Council voted 7-0 on second and final reading to approve a six-month data center moratorium, effective October 2026 through March 31, 2027. Source
- Port Huron Township, MI: Temporary data center moratorium. The Port Huron Township board unanimously adopted a temporary moratorium on new applications for data centers and other high-demand power users, lasting up to a year or until permanent zoning rules take effect. Source
- Gloucester Township (Camden County), NJ: Ordinance prohibiting large-scale data centers. Gloucester Township Council adopted Ordinance O-26-16, amending the Land Development Ordinance to designate data centers a prohibited land use in all zoning districts. The clerk’s certification gives the adoption date as Sept. 14, 2026, not Sept. 15. Source
- Middletown Township (Monmouth County), NJ: Proposed ordinance prohibiting data centers in all zones. The Township Committee introduced Ordinance 2026-3536 on September 8, 2026, which would list data centers as a prohibited use in every zoning district. A public hearing and final vote were scheduled for September 21, 2026. Source
- Millburn Township (Essex County), NJ: Proposed ordinance prohibiting large data centers. The Township Committee introduced Ordinance 2770-26 (Zoning Data Centers), with a public hearing set for October 6, 2026. On September 17, 2026, the Planning Board found the draft inconsistent with the master plan and requested further review. Source
- City of Buffalo, NY: Proposed two-year data center moratorium. The Common Council advanced a proposed two-year moratorium on new data centers and cryptocurrency facilities of 20 MW or more in September 2026, with a full council vote scheduled for the following Tuesday. Source
- Columbus County, NC: Proposed temporary data center moratorium. The Columbus County Board of Commissioners scheduled an October 5, 2026 public hearing on a temporary pause on data center development; the county attorney proposed 90 days and one commissioner proposed 120 days. Source
- Guilford County, NC: Proposed data center moratorium of up to 180 days. On September 17, 2026, the Guilford County Board of Commissioners voted unanimously to schedule an October 15 legislative public hearing on a proposed moratorium of up to 180 days on data center projects. Source
- Bridgewater Township (Williams County), OH: 12-month data center moratorium. Bridgewater Township trustees approved a 12-month moratorium on data centers, as reported on September 17, 2026. Source
- City of Warren (Trumbull County), OH: One-year data center moratorium. Warren City Council unanimously approved a one-year moratorium on the construction, placement, expansion or approval of data centers larger than 1,000 square feet. It also directed the mayor to form a Data Center Review Committee to report within nine months. Source
- Fayette County, OH: Temporary data center moratorium (seven townships). Fayette County commissioners approved a temporary moratorium on data center applications and permits covering seven unincorporated townships (Jefferson, Wayne and Union townships keep independent zoning). Commissioners Garland and Fleak approved it; it runs through June 1, 2027. Source
- Granville, OH: Charter amendment capping data center load on November ballot. A citizen petition to ban data centers drawing over 25 megawatts is on the November 3, 2026 ballot in Granville. Source
- Northwest Township (Williams County), OH: Data center moratorium. Northwest Township trustees approved a data center moratorium, as reported on September 10, 2026. The term was not available in the published excerpt. Source
- Oregon, OH: Charter amendment capping data center load on November ballot. A citizen petition to ban data centers drawing over 25 megawatts is on the November 3, 2026 ballot in Oregon, Ohio. Source
- Sunbury, OH: Charter amendment capping data center load on November ballot. A citizen-initiated charter amendment to ban data centers drawing over 25 megawatts is on the November 3, 2026 ballot in Sunbury. Source
- Urbana, OH: Charter amendment banning data centers over 7.5 MW on November ballot. Urbana voters will decide on November 3, 2026 on a charter amendment to ban data centers that draw over 7.5 megawatts. Source
- Warren County, OH: Proposed temporary data center moratorium. At a September 22, 2026 work session, Warren County commissioners directed the prosecutor’s office to draft a temporary data center moratorium resolution. A public hearing is to be scheduled before any vote. Source
- Washington County, OR: County declines to pursue data center moratorium. The Washington County Board of Commissioners decided in early September 2026 not to move forward with a data center pause, citing limited opportunities for such facilities in unincorporated areas the county oversees. Source
- Cumberland, RI: Zoning ordinance listing data centers as a prohibited use. The Town Council voted 6-1 on September 16, 2026, to adopt Ordinance 26-22 listing data centers as a prohibited use in the town zoning ordinance. Source
- Salt Lake County, UT: Proposed 180-day data center temporary land use regulation. The Salt Lake County Council unanimously adopted a resolution on Tuesday, Sept. 15, 2026 directing staff to develop data center regulations for unincorporated areas. Under the resolution the county will not consider new data centers until the rules are adopted, expected by mid-February 2027. This is a resolution-based pause, not a formally adopted 180-day moratorium ordinance. Source
Newly verified local measures from earlier periods
These actions were taken before this reporting period and were added once a primary source was confirmed. They are research gains, not new activity.
- Commerce, CA: 45-day urgency moratorium on data centers. The City of Commerce City Council adopted an urgency ordinance in August 2026 prohibiting approval of land use permits, entitlements or agreements for data centers for 45 days, with a possible extension of up to 10 months and 15 days after a public hearing. Source
- Whittier (Los Angeles County), CA: Council directs staff to draft data center urgency moratorium. On Aug. 25, 2026, Whittier City Council voted 5-0 to direct staff to study data centers and other land uses and return with moratorium options and longer-term rules. No urgency ordinance was adopted at that meeting. Source
- Albany, GA: Albany data center moratorium (proposed). On July 28, 2026, the Albany City Commission unanimously approved a 12-month moratorium on new data center development, with an option to extend six months, and directed the planning commission to draft regulations. Source
- Meriwether County, GA: Data center moratorium extended 90 days. The Meriwether County Board of Commissioners voted on July 28, 2026 to extend the data center moratorium, due to expire Aug. 23, by 90 days to Nov. 21, 2026 while staff drafts an ordinance. Vote date corrected from 7-30 to 7-28. Source
- Iowa County, IA: 12-month data center moratorium (Resolution 2026-07-31). The Iowa County Board of Supervisors adopted Resolution 2026-07-31, a 12-month moratorium on accepting, processing or approving applications for all classes of data centers in unincorporated Iowa County. Source
- Page County, IA: Temporary data center moratorium. The Page County Board of Supervisors approved a moratorium on data centers by a 2-1 vote on Tuesday, July 21, 2026, to allow time to review county zoning. Date corrected from 7-22 (KMA article dated July 21 reports the Tuesday vote). Source
- Lewiston, ME: City council rejection of proposed data center. The City Council unanimously voted down a proposed data center project in December 2025. Source
- Sabattus (Androscoggin County), ME: Proposed temporary data center moratorium. The Sabattus Select Board voted to call a special town meeting for residents to vote on a data center moratorium while the Planning Board drafts an ordinance; no meeting date was set. The board vote was Tuesday, July 21, 2026 (article dated July 22). No result of a town meeting vote was found. Source
- Leominster, MA: Proposed one-year data center pause. The City Council voted unanimously to schedule a September 14, 2026 public hearing on two petitions for one-year pauses on data centers and battery storage. Source
- Burlington Township (Calhoun County), MI: Temporary moratorium on data centers and battery storage. The Burlington Township Board unanimously adopted Ordinance 2026-8-13A, a non-zoning temporary moratorium on data centers and battery energy storage systems, and passed Resolution 2026-8-13B directing the Planning Commission to draft a zoning text amendment. Source
- Greenwich Township (Warren County), NJ: Ordinance prohibiting data centers. This is Greenwich Township in Warren County (Stewartsville), not Gloucester County. Ordinance 107-2026, prohibiting data centers, was introduced April 16, 2026 with a final hearing set for May 21, 2026; the township’s legal notices page lists the second reading and adoption notice. Source
- Hampton Township (Sussex County), NJ: Ordinance prohibiting data centers in all zones. The Hampton Township Committee adopted Ordinance 2026-13, amending Chapter 108 Zoning to prohibit data centers in all zones, by a 5-0 roll call on June 29, 2026. The posted minutes are marked as not yet formally approved. Source
- Hardyston Township (Sussex County), NJ: Ordinance prohibiting data centers in all zones. The Township Council unanimously adopted Ordinance 2026-12 on June 24, 2026, designating data centers a prohibited use in all zones. Source
- Ridgefield Park (Bergen County), NJ: Ordinance prohibiting data centers in all zones. The Ridgefield Park Board of Commissioners adopted Ordinance 2026-13, amending Chapter 96 to prohibit data centers in all zones, on second reading June 9, 2026 by a 4-0 vote with one commissioner absent. It was introduced May 26, 2026. Source
- Town of Dryden (Tompkins County), NY: Ban on data centers and cryptocurrency mines. The Town of Dryden banned data centers and cryptocurrency mines in February 2026, following an earlier 18-month land-use moratorium. Source
- Clyde, NC: 12-month data center moratorium. In April 2026, the Town of Clyde in Haywood County enacted a 12-month moratorium barring acceptance of zoning, conditional use, site plan, building and other development approvals for data centers within town limits. Source
- Jackson County, NC: One-year data center moratorium. On August 18, 2026, Jackson County commissioners unanimously adopted a one-year moratorium ordinance on new data center development, in effect through August 18, 2027, while the county studies potential regulations. Source
- Woodfin, NC: 12-month data center moratorium. On May 19, 2026, the Woodfin Town Council approved a 12-month moratorium on data center development while the town updates its land development ordinance. Source
- Green Township (Harrison County), OH: Moratorium on new development amid data center proposals. Green Township trustees approved a moratorium of at least 12 months on new development while a newly formed township zoning commission drafts rules to prohibit or restrict data centers. Source
- Jackson Township (Franklin County), OH: One-year data center moratorium. Jackson Township trustees unanimously approved a one-year moratorium on all data centers on unincorporated land in the township, effective immediately. Source
- Madison Township (Lake County), OH: 12-month data center moratorium. Madison Township trustees unanimously approved a 12-month moratorium on data center permits to study whether to limit or prohibit data centers, following opposition to a proposed project in nearby Perry Village. Source
- Cummings Township (Lycoming County), PA: 180-day moratorium on data center applications. Cummings Township supervisors adopted Resolution 07.14.2026.01, a moratorium on applications for data centers allowing 180 days to prepare a curative amendment to the zoning ordinance. Source
- East Vincent Township (Chester County), PA: Denial of Pennhurst data center conditional use. The Board of Supervisors unanimously denied a conditional use application for a 1.9 million-square-foot data center at the former Pennhurst site in May 2026. The developer said it would appeal. Source
- Jessup Borough (Lackawanna County), PA: Denial of Breaker Street data center campus. The Jessup Zoning Hearing Board unanimously denied plans for a data center campus on Breaker Street on December 23, 2025, finding the proposed substation could not be placed in the residential zone. Source
- Olyphant Borough (Lackawanna County), PA: Six-month data center moratorium. Borough Council voted 4-3 on April 15, 2026, to place a six-month moratorium on data center development while it drafts a data center ordinance. Source
- Dickson County, TN: Six-month moratorium on data center rezonings. The Dickson County Commission approved a six-month moratorium on data centers at its regular meeting on Monday, July 20, 2026. Date corrected from 7-21 to 7-20. The claim that it was kept in place on Sept. 9 was not independently confirmed. Source
- Wilson County, TN: Temporary data center moratorium. The Wilson County Commission unanimously approved a resolution imposing a six-month moratorium, running from July 20, 2026, on applications and permits for data centers and high-density computing facilities, and created a study committee. Date corrected from 7-21 to 7-20. Source
- Austin County, TX: Moratorium on AI data centers and battery energy storage systems. Austin County Commissioners Court unanimously adopted a countywide moratorium on new AI data center and battery energy storage developments in unincorporated areas while the county evaluates impacts and a possible energy development zone. Source
- Skamania County, WA: Six-month data center moratorium (Resolution 2026-22). The Skamania County Board of County Commissioners unanimously adopted Resolution 2026-22 on August 18, 2026, imposing a data center moratorium of up to six months, renewable after hearings. State law requires a public hearing within 60 days of adoption. Source
- Town of Janesville (Rock County), WI: Town of Janesville (Rock County) data center moratorium (proposed). The Town of Janesville board of supervisors approved a 12-month data center moratorium after its planning and zoning committee recommended one. Source
Status changes, local measures
- Pima County, AZ: Proposed to In force. The Pima County Board of Supervisors voted 3-2 in September 2026 to approve a 120-day moratorium on data center projects in unincorporated areas that have not yet submitted permits, while staff drafts zoning rules. Project Blue and Project Gravel are exempt; the board may consider an extension. Source
- Commerce City, CO: Proposed to In force. Commerce City Council passed an ordinance 7-1 in September 2026 barring acceptance of new data center applications for six months while the city develops regulations. Source
- Thornton, CO: Proposed to In force. Thornton City Council voted 5-3 in September 2026 to adopt a one-year moratorium applying to data centers larger than 50,000 square feet while the city develops regulations. Source
- New Haven, CT: Proposed to In force. The Board of Alders unanimously approved a 12-month moratorium on new data centers on September 22, 2026, with an exception for quantum computing or life sciences research facilities tied to the New Haven Quantum and Life Sciences Innovation Cluster. Source
- Leon County, FL: In force to Proposed. County commissioners voted unanimously on July 14, 2026 in favor of an 18-month moratorium on large-scale data centers. On Sept. 15, 2026 the commission unanimously advanced the moratorium ordinance, which covers large-load customer facilities including large-scale data centers; the second and final public hearing is scheduled for Oct. 13, 2026. The Tallahassee City Commission declined to adopt a parallel measure. Source
- North Port, FL: Proposed to In force. On September 22, 2026, the North Port City Commission voted 3-2 on second reading to adopt an 18-month moratorium on new data center applications; a roughly 900,000-square-foot facility already proposed is excluded. Source
- Palm Beach County, FL: Proposed to In force. On September 24, 2026, Palm Beach County commissioners unanimously gave final approval to a one-year moratorium on new hyperscale data centers with peak load of at least 50 megawatts in unincorporated areas. Source
- Marshall County, IA: Proposed to In force. The Marshall County Board of Supervisors unanimously adopted a resolution imposing a six-month moratorium on applications for data centers, AI computing, data mining and cryptocurrency mining facilities in unincorporated areas. Source
- North Mankato, MN: Proposed to In force. North Mankato City Council adopted a 12-month data center moratorium and study on September 21, 2026, after tabling the ordinance in August. It may be renewed for an additional year. Source
- Woodbury, MN: Proposed to In force. Woodbury City Council approved a moratorium of up to one year on new data centers and expansions beyond existing approvals while the city studies water, power, noise and zoning. Source
- Raton, NM: Proposed to Failed / vetoed. The Raton City Commission voted 3-2 in September 2026 against a resolution that would have imposed a one-year moratorium on business licenses and zoning approvals for data centers. Source
- Hendersonville, NC: Proposed to In force. Following a September 3, 2026 public hearing, the City of Hendersonville has a one-year moratorium on data center development in place, according to a WLOS roundup of western North Carolina moratoriums. Source
- Plain City, OH: Proposed to In force. Plain City Village Council passed Ordinance 37-2026, an emergency ordinance establishing a one-year moratorium on accepting development applications that include data centers. First reading Aug. 5, second reading and passage Aug. 10, 2026 (5-0). Source
- Salem, OR: Proposed to In force. Salem City Council voted 7-0, with two members absent, on September 21, 2026 to adopt a 120-day moratorium on all new AI data center projects in Salem, effective immediately. Source
- Kershaw County, SC: Proposed to In force. On September 22, 2026, Kershaw County Council unanimously passed on third and final reading a one-year moratorium on data centers, cryptocurrency mining operations and data processing facilities. Source
- Spartanburg County, SC: Proposed to In force. On September 21, 2026, Spartanburg County Council voted 5-1 on third reading to approve a one-year moratorium on new data centers larger than 65 megawatts, with amendments; previously approved projects such as the Valara data center are not affected. Source
Removals
No entries were removed. The tracker merges forward: a sourced entry stays on the list unless a new source shows its status changed or it was formally repealed.
How this tracker is maintained
The tracker is refreshed weekly. Every entry requires a verifiable primary source: a legislature page, a governor’s office, a local government record, or established news reporting. Entries are merged rather than replaced, so a measure verified in an earlier week is not dropped because a later pass did not resurface it. Where a measure is single-sourced or a date could not be independently confirmed, the entry says so.
The full dataset, with a filterable map and all 1010 citations, is at the U.S. Data Center Moratorium Tracker. The complete source list is at the tracker’s sources page.
Would you like the weekly update?
Every week we re-verify every state and local measure on this map and publish what changed. You get one email when it goes out.
Also send me
Receive a short introduction on days 3, 7 and 14, plus the updates you select. Unsubscribe in one click. Privacy
Data Center Moratorium Tracker Update: September 28, 2026
Get new SAVRN Insights by email
A short introduction on days 3, 7 and 14, plus new SAVRN research articles. Unsubscribe at any time.
We use your address to send the introduction and updates described above. See our Privacy Policy.
